From 30 Random To-Dos to One Logical Sequence of Action

Dependency mapping for goals transforms a chaotic task list into a clear sequence where each completed step unlocks the next. You’ve probably experienced the opposite: breaking a big goal into smaller tasks, feeling proud of your detailed list, then staring at 30 items with no idea where to start. You pick something that feels productive, work on it for an hour, then realize you needed to finish something else first. The cover letter you wrote needs revision because you hadn’t researched the company yet. The chapter you drafted contradicts plans you hadn’t finalized. The habit tracker you built tracks habits you haven’t chosen.

Most goal-setting advice stops at “break it down into smaller steps.” But a long list of small tasks is still overwhelming without a clear task order. This guide teaches you dependency mapping: a simple system for identifying which tasks unlock others, where the bottlenecks hide, and what to do first so every action creates forward momentum.

What is dependency mapping for goals?

Dependency mapping is a system for identifying which tasks must precede others and sequencing your work so each completed step unlocks the next. The process involves: (1) listing all tasks, (2) identifying dependencies, (3) finding bottlenecks, (4) creating a visual map, and (5) working from entry points toward completion.

What You’ll Learn

Key Takeaways

  • Task sequencing prevents wasted effort from completing work in the wrong order
  • A dependency exists when Task B cannot start or finish well until Task A is complete
  • Bottleneck tasks block the most downstream work and deserve priority regardless of how urgent they feel [2]
  • Independent tasks with no dependency relationship can run in parallel, accelerating progress
  • A simple visual map of dependencies beats trying to keep sequences in your head
  • Weekly reviews catch dependency changes before they cause rework or stalled progress
  • Starting with “what unlocks the most?” produces better results than starting with “what feels urgent?”

Why Task Order Matters More Than Most People Realize

Breaking goals into small tasks solves the “too big to start” problem. But it creates a new problem: a long list with no clear entry point. When everything looks equally doable, random selection leads to wasted effort.

The Wrong-Order Trap

Consider these common scenarios:

  • You spend an hour writing a cover letter, then realize you haven’t researched the company well enough to customize it properly
  • You draft chapter three of your book, then discover it contradicts decisions you haven’t made about chapter one
  • You build an elaborate habit tracker before deciding which habits actually matter to you
  • You practice a presentation before confirming what your audience needs to hear

Each example involves real work on a legitimate task. But the work happened too early in the sequence, meaning it either needs revision or provided less value than it could have.

What Research Tells Us

Goal-setting research consistently shows that specific, challenging goals with clear feedback produce higher performance than vague intentions [1]. But feedback requires knowing whether your current action actually moves you forward. Without understanding the correct task order, you can’t accurately judge progress. You might feel busy while making little real headway.

“Specific, challenging goals with clear feedback produce higher performance than vague goals or ‘do your best’ instructions.” [1]

A task completed in the wrong order isn’t progress. It’s inventory that may require rework once you complete the tasks that should have preceded it.

The Dependency Insight

Some tasks can only produce full value after other tasks are complete. Identifying these relationships transforms a flat list into a logical sequence. Instead of asking “what should I do?” you ask “what can I do that unlocks the most?” Starting with “what unlocks the most?” produces better results than starting with “what feels urgent?” because it ensures every completed task enables future progress.

Dependency Mapping Fundamentals: The Language of Task Relationships

What Is a Dependency?

A dependency exists when Task B cannot start, or cannot be completed well, until Task A is finished. Task A is the predecessor; Task B is the successor. The relationship flows in one direction: completing A enables B, but completing B does nothing to help A.

Examples of dependencies:

  • “Update resume” must happen before “submit job application”
  • “Research chapter topic” must happen before “draft chapter content”
  • “Choose which habit to build” must happen before “design a tracking system for that habit”
  • “Get feedback on draft” must happen before “finalize and publish”

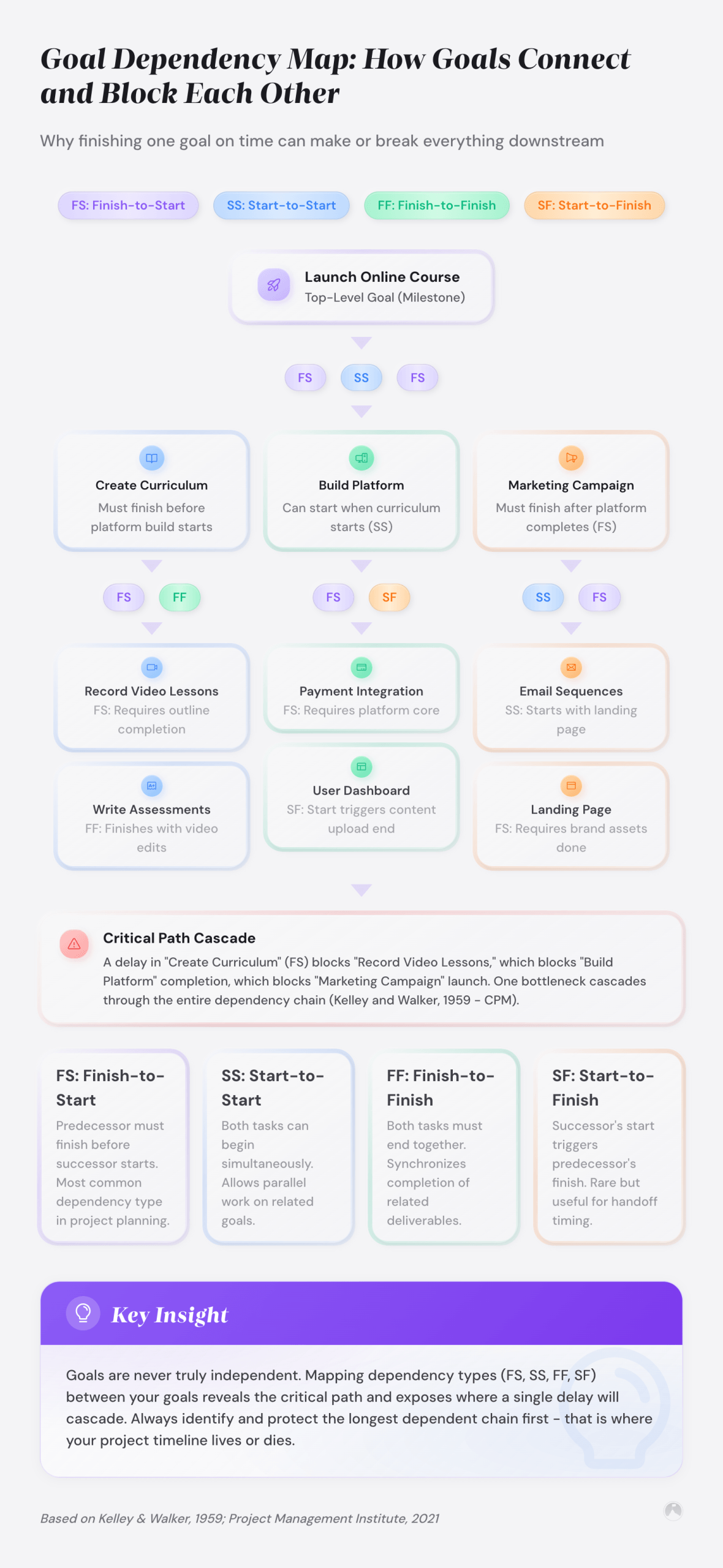

Types of Task Dependencies

Not all dependencies work the same way. Understanding the type helps you decide how strictly to enforce the sequence.

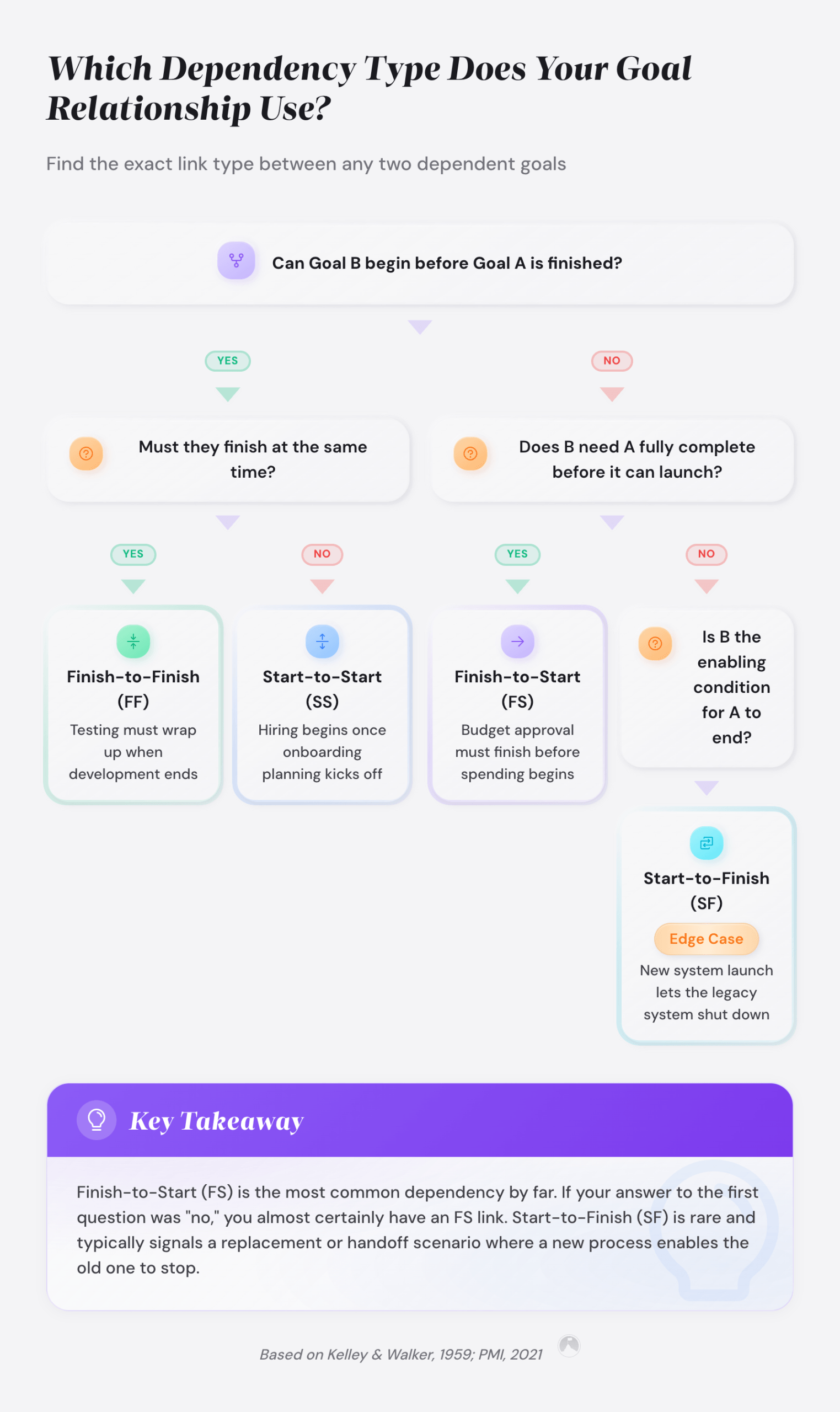

TypeDefinitionExampleHow to Handle
Hard dependencyB literally cannot start without A being completeCannot submit application without a resume to attachAlways sequence A before B
Soft dependencyB is significantly easier or better quality after AWriting flows easier after completing an outlineUsually sequence A first, but can skip if time-pressed
Information dependencyB needs information or decisions that A producesCreating a budget requires knowing your expensesComplete A first, or estimate and plan to revise B later
Resource dependencyA and B need the same limited resourceTwo tasks both require your peak-focus morning hoursSchedule sequentially rather than attempting parallel work

Critical Path and Independent Tasks

Not every task depends on another. Independent tasks have no predecessor-successor relationship and can happen in any order or even simultaneously. Recognizing independence gives you flexibility to match tasks to your available time and energy.

In project management, the sequence of bottleneck tasks from start to finish is sometimes called the critical path [2]. For personal goals, you don’t need formal critical path analysis, but the principle applies: identify the chain of dependent tasks that determines your minimum timeline.

Dependency mapping reveals which tasks have a required order and which give you freedom to choose based on energy, time, or preference.

For example, if your goal involves both “research industry trends” and “update LinkedIn profile,” these might be independent. Neither blocks the other. You can do whichever fits your current situation. But if “research industry trends” informs how you position yourself on LinkedIn, then a soft dependency exists and sequencing research first produces a better outcome.

The 5-Step Dependency Mapping Process

This process works for career transitions, creative projects, health goals, financial targets, learning objectives, or any goal that involves multiple tasks over time.

Step 1: List All Tasks Without Filtering

Brain-dump every task you can think of for your goal or current milestone. Don’t worry about order, size, or dependencies yet. The objective is completeness, not organization.

Write tasks as specific actions when possible: “research three competing products” rather than just “do research.” But don’t get stuck on perfect wording. You can refine later.

If you need help breaking a large goal into smaller tasks before mapping dependencies, see our guide to micro-goal setting for busy schedules.

Step 2: Identify Dependencies by Asking “What Must Happen First?”

For each task on your list, ask: “Is there anything that must be completed before I can do this task well?”

Write dependencies as simple arrows: Task A → Task B means A must precede B.

A practical test: imagine completing Task B first, before Task A. Would you likely need to redo Task B after finishing Task A? If yes, a dependency exists. If Task B would stand unchanged regardless of when you do Task A, no dependency exists between them.

Step 3: Find Your Bottlenecks

A bottleneck is a task that blocks the most downstream work. Multiple successor tasks depend on it, directly or through chains of other dependencies.

Bottleneck tasks don’t always feel urgent, but completing them unlocks more progress than any other single action you could take. Research on project scheduling confirms that identifying and prioritizing bottleneck tasks reduces overall completion time [2].

To find bottlenecks:

  • For each task, count how many other tasks depend on it (directly or through chains)
  • Tasks with the highest dependency counts are your bottlenecks
  • These deserve priority even if they’re not exciting or don’t feel pressing

A single bottleneck task completed early can unblock more progress than five non-bottleneck tasks combined. A bottleneck might be something mundane like “gather all required documents” or “make one key decision.” The task itself may take only 30 minutes. But until it’s done, five other tasks sit blocked.

Step 4: Create a Simple Visual Map

Draw your tasks and dependencies as a flowchart or network diagram. This doesn’t require special software. Boxes and arrows on paper or a whiteboard work fine. Digital tools like simple drawing apps or even a text outline with indentation can work.

Common visual structures:

StructureWhen It AppearsWhat It Looks Like
Linear chainSimple sequential goalsA → B → C → D
Branching treeParallel paths that later convergeA → B and A → C, then B → D and C → D
NetworkComplex projects with many interconnectionsMultiple crossing dependency lines

Your map should make clear which tasks have no predecessors (starting points), which have no successors (endpoints representing completion), and which sit in the middle as bridges.

Step 5: Task Sequencing from Bottlenecks to Completion

With your map complete, task sequencing becomes straightforward:

  1. Identify tasks with no predecessors. These are your possible starting points since nothing blocks them.
  2. Among starting-point tasks, prioritize any that are bottlenecks (unlocking the most downstream work).
  3. As you complete tasks, new tasks become unblocked. Move to those next.
  4. Continue until you reach tasks with no successors, which represent goal completion.

This approach means you’re always working on something that either directly advances your goal or unlocks future work. No more wasted effort on tasks that should have waited.

Dependency Mapping in Action: Career Transition Example

Let’s see the full process applied to a realistic goal.

The Scenario

You want to transition from marketing to UX design within 12 months. You have a full-time job and limited hours for career development. You’ve brainstormed tasks but feel overwhelmed about where to start.

Step 1: Raw Task List

  • Research UX design roles and requirements
  • Update LinkedIn profile for UX positioning
  • Complete an online UX fundamentals course
  • Build a portfolio website
  • Create case study #1
  • Create case study #2
  • Create case study #3
  • Network with UX professionals
  • Get resume reviewed by someone working in UX
  • Apply to 10 UX positions
  • Prepare for UX interview questions

Step 2: Dependencies Identified

Asking “what must happen first?” reveals these relationships:

  • Research UX roles → informs nearly everything else (what to learn, how to position, what portfolio should show)
  • Complete UX course → needed before creating credible case studies
  • Create case studies (1, 2, 3) → needed before portfolio is meaningful
  • Case studies complete → portfolio can be finalized
  • Portfolio ready + Resume reviewed → ready to apply
  • Network with UX pros → can happen in parallel, but helps with resume review

Step 3: Bottleneck Analysis

“Research UX roles” blocks almost everything downstream. It’s a clear bottleneck. Until you understand what UX roles require, you can’t make good decisions about courses, portfolio content, or positioning.

“Complete UX course” is the second major bottleneck. Case studies require the knowledge and credibility the course provides.

The three case studies collectively block portfolio completion, which blocks applications.

Step 4: Visual Map

Research UX roles
       ↓
Complete UX course ←──────────────┐
       ↓                          │
┌──────┼──────┐                   │
↓      ↓      ↓                   │
Case 1 Case 2 Case 3    Network with UX pros
└──────┼──────┘                   │
       ↓                          │
  Build portfolio ←───────────────┘
       ↓                          │
Update LinkedIn + Get resume reviewed
       ↓
  Apply to positions
       ↓
Prepare for interviews

Step 5: Sequenced Action Plan

TimeframeFocusRationale
Weeks 1-2Research UX roles thoroughlyUnblocks all downstream decisions
Weeks 3-8Complete UX course; begin networking in parallelCourse is next bottleneck; networking has no blockers
Weeks 9-16Create three case studiesCan work on these in parallel once course knowledge is solid
Weeks 17-18Finalize portfolio; get resume reviewedNetworking pays off here with review contacts
Weeks 19+Apply to positions; prepare for interviewsEverything needed is now in place

Without dependency mapping, you might have started by updating LinkedIn or jumping into applications with a weak portfolio. The map reveals why research and coursework must come first, even though they feel less like “real progress” than submitting applications.

Handling Complex Dependencies and Parallel Work

When to Work in Parallel

Independent tasks can happen simultaneously when you have the time and energy. This accelerates your timeline. In the career transition example, networking can run in parallel with coursework because neither depends on the other being complete.

Parallel work is safe when:

  • Neither task’s output affects the other
  • The tasks don’t compete for the same limited resource (like your morning focus hours)
  • You won’t need to redo either task based on the other’s results

When Parallel Work Backfires

Attempting parallel work with hidden dependencies creates problems. Research on task switching shows that shifting between related tasks reduces efficiency and increases errors [3]. You end up context-switching between related tasks, doing rework when one task’s output changes what the other needed, or producing lower quality because attention is divided.

Warning signs that tasks shouldn’t run in parallel:

  • You keep pausing one task to check on the other
  • Decisions in one task affect decisions in the other
  • Both tasks require your best cognitive energy at the same time

Example: You’re simultaneously researching two job industries and updating your resume for each. Mid-way through, you realize insights from industry A research would change how you position yourself for industry B. Now you need to redo the industry B resume section. Sequential research would have prevented this rework.

The Convergence Problem

When multiple parallel paths must converge before a downstream task can start (like needing all three case studies before finalizing a portfolio), the slowest path determines your timeline. If case study #2 hits delays while #1 and #3 finish early, the portfolio still waits.

The slowest parallel path determines your timeline when multiple tasks must converge before downstream work can begin.

Manage convergence by:

  • Identifying convergence points explicitly in your map
  • Monitoring all paths feeding into them
  • Starting the riskiest or most uncertain parallel task first, so delays surface early

Maintaining Your Dependency Map

A dependency map isn’t a one-time creation. Goals evolve, circumstances change, and you learn things that alter what needs to happen. Regular maintenance keeps your map useful.

Weekly Review Questions

Spend five minutes each week asking:

  • Did I complete any tasks that unlock new ones? (Update the map to reflect new available tasks)
  • Did I discover dependencies I hadn’t anticipated? (Add them)
  • Are any bottlenecks stuck? What’s actually blocking them?
  • Have circumstances changed, making some tasks unnecessary? (Remove them)
  • Did new tasks emerge that I need to add and sequence?

When to Rebuild vs. Adjust

Small changes warrant adjustments to your existing map: adding a new task, removing one that’s no longer relevant, or correcting a dependency you got wrong.

Large changes warrant rebuilding from scratch: a major goal pivot, a significant obstacle that blocks most of your plan, or new information that fundamentally changes what you need to do. Rebuilding takes more time but ensures your map reflects current reality rather than outdated assumptions.

Connecting to Your Broader System

Dependency mapping handles task sequencing within a goal. It works alongside other productivity approaches:

Frequently Asked Questions

How is dependency mapping different from making a to-do list?

A to-do list is flat. All tasks appear as equals, and you pick based on whatever feels right in the moment. Dependency mapping adds structure by showing which tasks must precede others and which unlock the most downstream work. This transforms random task selection into strategic sequencing where every completed item enables future progress.

What if I don’t know all the tasks upfront?

Start with what you know. Dependency mapping is iterative. You’ll discover new tasks as you make progress and learn more about what your goal requires. The map helps you insert new tasks into the correct place in the sequence rather than just adding them to the bottom of an ever-growing list.

How detailed should my dependency map be?

Match detail to complexity. A straightforward goal like completing a certification might need only 8-12 tasks mapped. A complex goal like a career change might involve 30 or more. If your map feels overwhelming to look at, you may be tracking tasks at too granular a level. Zoom out by combining small tasks into larger chunks until the map becomes manageable.

What do I do when a bottleneck task is stuck?

First, check whether the bottleneck itself has hidden dependencies you missed. Something might be blocking it that you haven’t identified. Second, see if you can split the bottleneck into smaller pieces. Perhaps part of it can complete and unlock some downstream work even if the rest remains stuck. Third, examine whether any downstream tasks can proceed with assumptions or partial information and be revised later when the bottleneck clears.

Can I use dependency mapping together with time-blocking or other scheduling methods?

Yes, and they complement each other well. Dependency mapping tells you what order to complete tasks. Scheduling methods like time-blocking tell you when to work on them. Use dependency mapping first to determine which tasks are available and which matter most, then schedule those prioritized tasks into your calendar using whatever method you prefer.

How do I handle tasks that depend on other people responding?

Mark external dependencies clearly on your map. You can’t control when someone else responds, but you can manage around it. Send requests early so waiting time runs in parallel with other work you can do independently. Keep backup tasks ready that don’t depend on that input. Consider setting a deadline after which you’ll proceed with your best assumptions and revise later if the input eventually arrives.

Is dependency mapping only useful for big goals or can I use it for weekly planning?

Both scales work. For weekly planning, a quick mental scan of dependencies helps you order your task list sensibly and avoid starting something that depends on unfinished work. For goals spanning months, a documented visual map prevents wasted effort and keeps you focused on high-value tasks. The underlying principle is identical; only the formality changes.

Conclusion

Breaking goals into small tasks is a necessary first step, but it’s not sufficient on its own. A long list of small tasks still creates overwhelm if you don’t know what task order to tackle them. Dependency mapping for goals provides that missing structure. By identifying which tasks unlock others and where the bottlenecks hide, you transform a chaotic list into a clear sequence where each completed step enables the next.

Task sequencing transforms a chaotic list into a clear progression where each completed step enables the next.

The system requires no special tools. List your tasks, identify predecessor-successor relationships, find the bottlenecks, sketch a simple visual map, and work from entry points toward your goal. Weekly reviews keep the map accurate as you learn and as circumstances shift.

The payoff is significant: less wasted effort, clearer priorities, and the confidence that comes from knowing your current action is the right one to take right now.

Next 10 Minutes

  • Choose one goal you’re currently working toward
  • List 10-15 tasks associated with that goal
  • For each task, ask: “What must happen before this can start or be done well?”
  • Identify one bottleneck task and schedule time to complete it this week

This Week

  • Create a simple visual map of your goal’s dependencies using paper or any drawing tool
  • Complete at least one bottleneck task that unlocks downstream work
  • Review your map at week’s end and update it based on what you learned
  • If you need help breaking a large goal into appropriately sized tasks, read our guide to microgoals for procrastination

References

[1] Locke EA, Latham GP. Building a practically useful theory of goal setting and task motivation: A 35-year odyssey. American Psychologist. 2002;57(9):705-717. https://doi.org/10.1037/0003-066X.57.9.705

[2] Kelley JE, Walker MR. Critical-path planning and scheduling. Proceedings of the Eastern Joint Computer Conference. 1959;160-173. https://doi.org/10.1145/1460299.1460318

[3] Monsell S. Task switching. Trends in Cognitive Sciences. 2003;7(3):134-140. https://doi.org/10.1016/S1364-6613(03)00028-7

Ramon Landes
